Skip to main content
In Weave, Scorers are used to evaluate AI outputs and return evaluation metrics. They take the AI’s output, analyze it, and return a dictionary of results. Scorers can use your input data as reference if needed and can also output extra information, such as explanations or reasonings from the evaluation.
Scorers are passed to a weave.Evaluation object during evaluation. There are two types of Scorers in weave:
  1. Function-based Scorers: Simple Python functions decorated with @weave.op.
  2. Class-based Scorers: Python classes that inherit from weave.Scorer for more complex evaluations.
Scorers must return a dictionary and can return multiple metrics, nested metrics and non-numeric values such as text returned from a LLM-evaluator about its reasoning.

Create your own Scorers

Ready-to-Use Scorers While this guide shows you how to create custom scorers, Weave comes with a variety of predefined scorers and local SLM scorers that you can use right away, including:

Function-based Scorers

These are functions decorated with @weave.op that return a dictionary. They’re great for simple evaluations like:
import weave

@weave.op
def evaluate_uppercase(text: str) -> dict:
    return {"text_is_uppercase": text.isupper()}

my_eval = weave.Evaluation(
    dataset=[{"text": "HELLO WORLD"}],
    scorers=[evaluate_uppercase]
)
When the evaluation is run, evaluate_uppercase checks if the text is all uppercase.

Class-based Scorers

For more advanced evaluations, especially when you need to keep track of additional scorer metadata, try different prompts for your LLM-evaluators, or make multiple function calls, you can use the Scorer class.Requirements:
  1. Inherit from weave.Scorer.
  2. Define a score method decorated with @weave.op.
  3. The score method must return a dictionary.
Example:
import weave
from openai import OpenAI
from weave import Scorer

llm_client = OpenAI()

class SummarizationScorer(Scorer):
    model_id: str = "gpt-4o"
    system_prompt: str = "Evaluate whether the summary is good."

    @weave.op
    def some_complicated_preprocessing(self, text: str) -> str:
        processed_text = "Original text: \n" + text + "\n"
        return processed_text

    @weave.op
    def call_llm(self, summary: str, processed_text: str) -> dict:
        res = llm_client.chat.completions.create(
            messages=[
                {"role": "system", "content": self.system_prompt},
                {"role": "user", "content": (
                    f"Analyze how good the summary is compared to the original text."
                    f"Summary: {summary}\n{processed_text}"
                )}])
        return {"summary_quality": res}

    @weave.op
    def score(self, output: str, text: str) -> dict:
        """Score the summary quality.

        Args:
            output: The summary generated by an AI system
            text: The original text being summarized
        """
        processed_text = self.some_complicated_preprocessing(text)
        eval_result = self.call_llm(summary=output, processed_text=processed_text)
        return {"summary_quality": eval_result}

evaluation = weave.Evaluation(
    dataset=[{"text": "The quick brown fox jumps over the lazy dog."}],
    scorers=[summarization_scorer])
This class evaluates how good a summary is by comparing it to the original text.

How Scorers Work

Scorer Keyword Arguments

Scorers can access both the output from your AI system and the input data from the dataset row.
  • Input: If you would like your scorer to use data from your dataset row, such as a “label” or “target” column then you can easily make this available to the scorer by adding a label or target keyword argument to your scorer definition.
For example if you wanted to use a column called “label” from your dataset then your scorer function (or score class method) would have a parameter list like this:
@weave.op
def my_custom_scorer(output: str, label: int) -> dict:
    ...
When a weave Evaluation is run, the output of the AI system is passed to the output parameter. The Evaluation also automatically tries to match any additional scorer argument names to your dataset columns. If customizing your scorer arguments or dataset columns is not feasible, you can use column mapping - see below for more.
  • Output: Include an output parameter in your scorer function’s signature to access the AI system’s output.

Mapping Column Names with column_map

Sometimes, the score methods’ argument names don’t match the column names in your dataset. You can fix this using a column_map.If you’re using a class-based scorer, pass a dictionary to the column_map attribute of Scorer when you initialize your scorer class. This dictionary maps your score method’s argument names to the dataset’s column names, in the order: {scorer_keyword_argument: dataset_column_name}.Example:
import weave
from weave import Scorer

# A dataset with news articles to be summarized
dataset = [
    {"news_article": "The news today was great...", "date": "2030-04-20", "source": "Bright Sky Network"},
    ...
]

# Scorer class
class SummarizationScorer(Scorer):

    @weave.op
    def score(self, output, text) -> dict:
        """
            output: output summary from a LLM summarization system
            text: the text being summarized
        """
        ...  # evaluate the quality of the summary

# create a scorer with a column mapping the `text` argument to the `news_article` data column
scorer = SummarizationScorer(column_map={"text" : "news_article"})
Now, the text argument in the score method will receive data from the news_article dataset column.Notes:
  • Another equivalent option to map your columns is to subclass the Scorer and overload the score method mapping the columns explicitly.
import weave
from weave import Scorer

class MySummarizationScorer(SummarizationScorer):

    @weave.op
    def score(self, output: str, news_article: str) -> dict:  # Added type hints
        # overload the score method and map columns manually
        return super().score(output=output, text=news_article)

Access variables from your ops in scoring prompts

In scoring prompts for LLM-as-a-judge scorers, you can reference variables from your op. These values are automatically extracted when the scorer runs. For a function like:
@weave.op
def summarize_article(article: str, max_length: int) -> str:
    # Your summarization logic here
    return summary
The following variables are available:
VariableDescription
{article}The value of the input argument article
{max_length}The value of the input argument max_length
{inputs}A JSON dictionary of all input arguments
{output}The result returned by your op
Example scoring prompt:
Evaluate the quality of this summary.

Original article: {article}
Summary: {output}
Maximum length requested: {max_length}

Rate the summary on a scale of 1-10 based on:
- Accuracy: Does it accurately represent the article?
- Completeness: Does it cover the key points?
- Conciseness: Is it appropriately brief?

Return a JSON object with your rating and reasoning.

Final summarization of the scorer

During evaluation, the scorer will be computed for each row of your dataset. To provide a final score for the evaluation we provide an auto_summarize depending on the returning type of the output.
  • Averages are computed for numerical columns
  • Count and fraction for boolean columns
  • Other column types are ignored
You can override the summarize method on the Scorer class and provide your own way of computing the final scores. The summarize function expects:
  • A single parameter score_rows: This is a list of dictionaries, where each dictionary contains the scores returned by the score method for a single row of your dataset.
  • It should return a dictionary containing the summarized scores.
Why this is useful?When you need to score all rows before deciding on the final value of the score for the dataset.
class MyBinaryScorer(Scorer):
    """
    Returns True if the full output matches the target, False if not
    """

    @weave.op
    def score(self, output, target):
        return {"match": output == target}

    def summarize(self, score_rows: list) -> dict:
        full_match = all(row["match"] for row in score_rows)
        return {"full_match": full_match}
In this example, the default auto_summarize would have returned the count and proportion of True.
If you want to learn more, check the implementation of CorrectnessLLMJudge.

Applying Scorers to a Call

To apply scorers to your Weave ops, you’ll need to use the .call() method which provides access to both the operation’s result and its tracking information. This allows you to associate scorer results with specific calls in Weave’s database. For more information on how to use the .call() method, see the Calling Ops guide.
Here’s a basic example:
# Get both result and Call object
result, call = generate_text.call("Say hello")

# Apply a scorer
score = await call.apply_scorer(MyScorer())
You can also apply multiple scorers to the same call:
# Apply multiple scorers in parallel
await asyncio.gather(
    call.apply_scorer(quality_scorer),
    call.apply_scorer(toxicity_scorer)
)
Notes:
  • Scorer results are automatically stored in Weave’s database
  • Scorers run asynchronously after the main operation completes
  • You can view scorer results in the UI or query them via the API
For more detailed information about using scorers as guardrails or monitors, including production best practices and complete examples, see our Guardrails and Monitors guide.

Use preprocess_model_input

You can use the preprocess_model_input parameter to modify dataset examples before they reach your model during evaluation. For usage information and an example, see Using preprocess_model_input to format dataset rows before evaluating.

Score Analysis

In this section, we’ll show you how to analyze the scores for a single call, multiple calls, and all calls scored by a specific scorer.

Analyze a single Call’s Scores

Single Call API

To retrieve the calls for a single call, you can use the get_call method.
client = weave.init("my-project")

# Get a single call
call = client.get_call("call-uuid-here")

# Get the feedback for the call which contains the scores
feedback = list(call.feedback)

Single Call UI

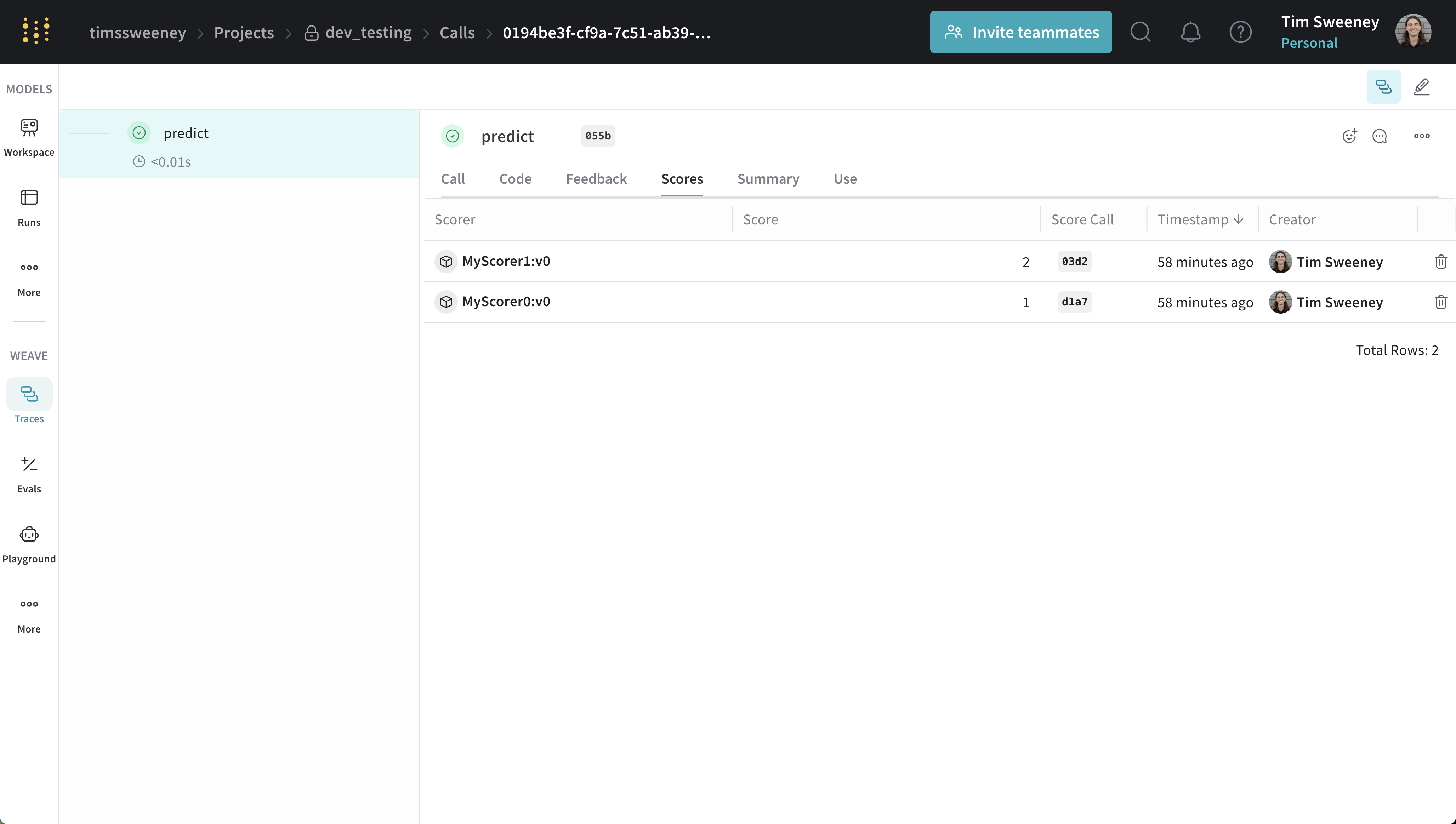

Call Scores Tab
Scores for an individual call are displayed in the Call details panel under the “Scores” tab.

Analyze multiple Calls’ Scores

Multiple Calls API

To retrieve the calls for multiple calls, you can use the get_calls method.
client = weave.init("my-project")

# Get multiple calls - use whatever filters you want and include feedback
calls = client.get_calls(..., include_feedback=True)

# Iterate over the calls and access the feedback which contains the scores
for call in calls:
    feedback = list(call.feedback)

Multiple Calls UI

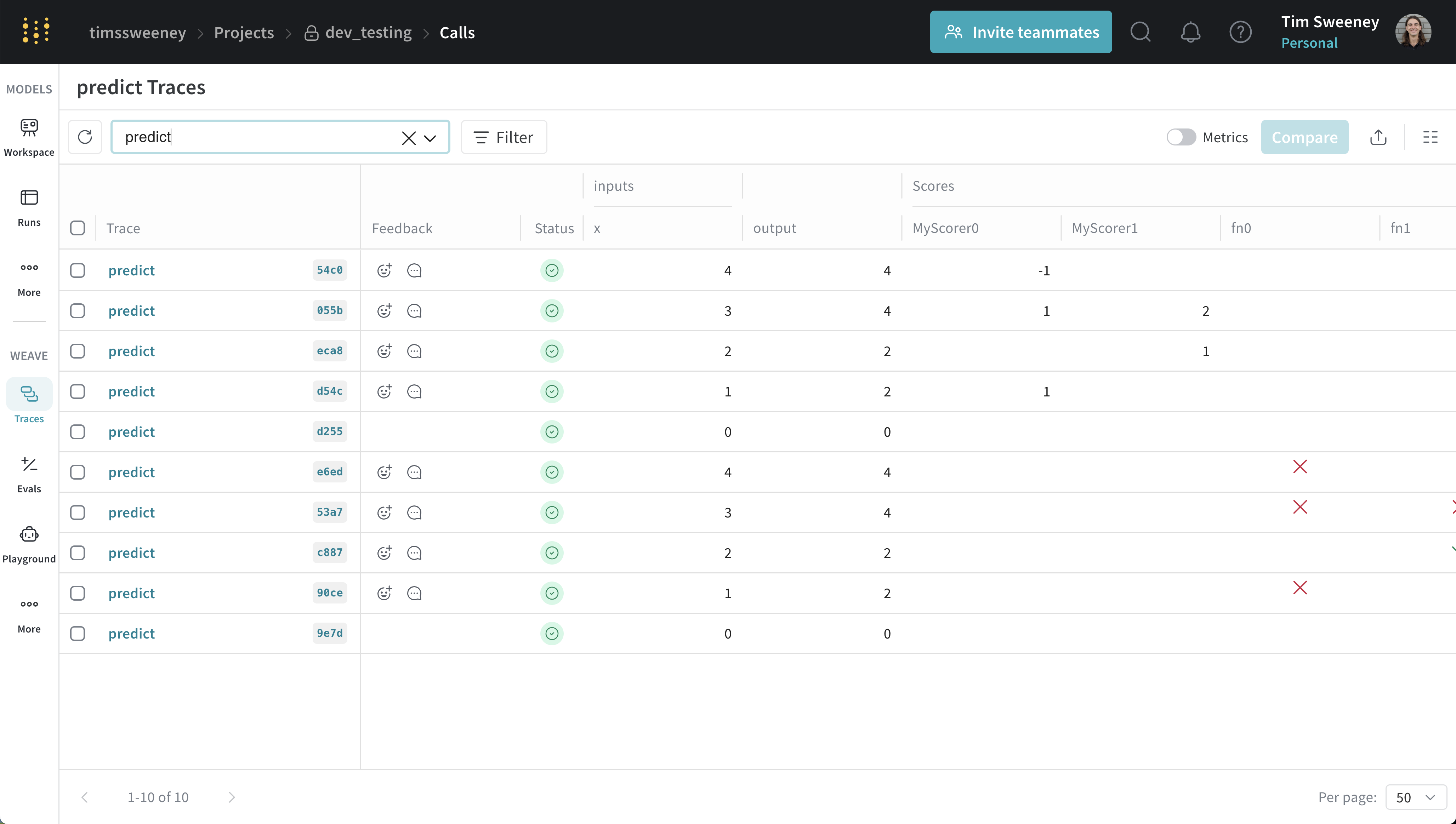

Multiple Calls Tab
Scores for multiple calls are displayed in the traces table under the “Scores” column.

Analyze all Calls scored by a specific Scorer

All Calls by Scorer API

To retrieve all calls scored by a specific scorer, you can use the get_calls method.
client = weave.init("my-project")

# To get all the calls scored by any version of a scorer, use the scorer name (typically the class name)
calls = client.get_calls(scored_by=["MyScorer"], include_feedback=True)

# To get all the calls scored by a specific version of a scorer, use the entire ref
# Refs can be obtained from the scorer object or via the UI.
calls = client.get_calls(scored_by=[myScorer.ref.uri()], include_feedback=True)

# Iterate over the calls and access the feedback which contains the scores
for call in calls:
    feedback = list(call.feedback)

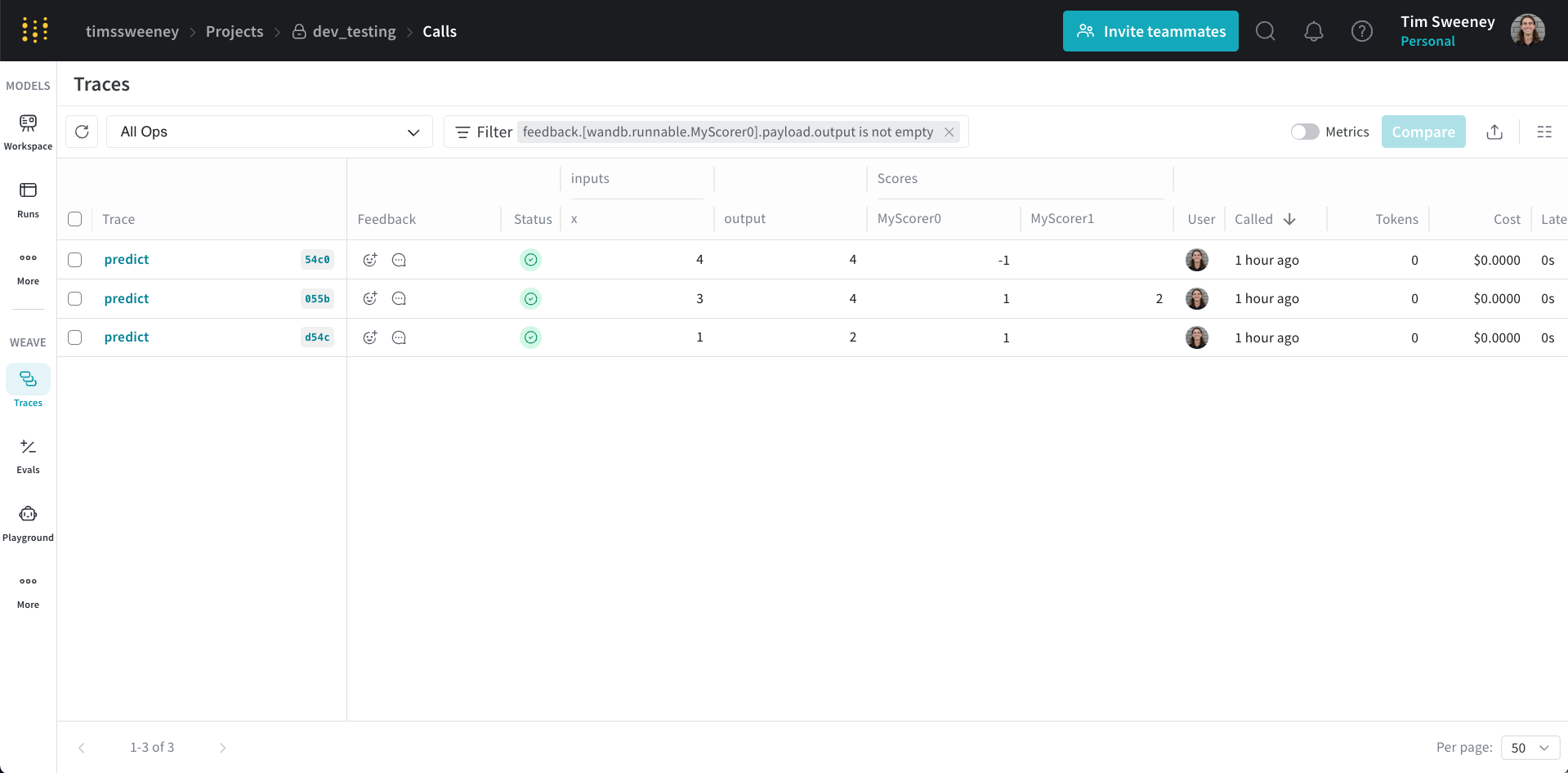

All Calls by Scorer UI

Finally, if you would like to see all the calls scored by a Scorer, navigate to the Scorers Tab in the UI and select “Programmatic Scorer” tab. Click your Scorer to open the Scorer details page.

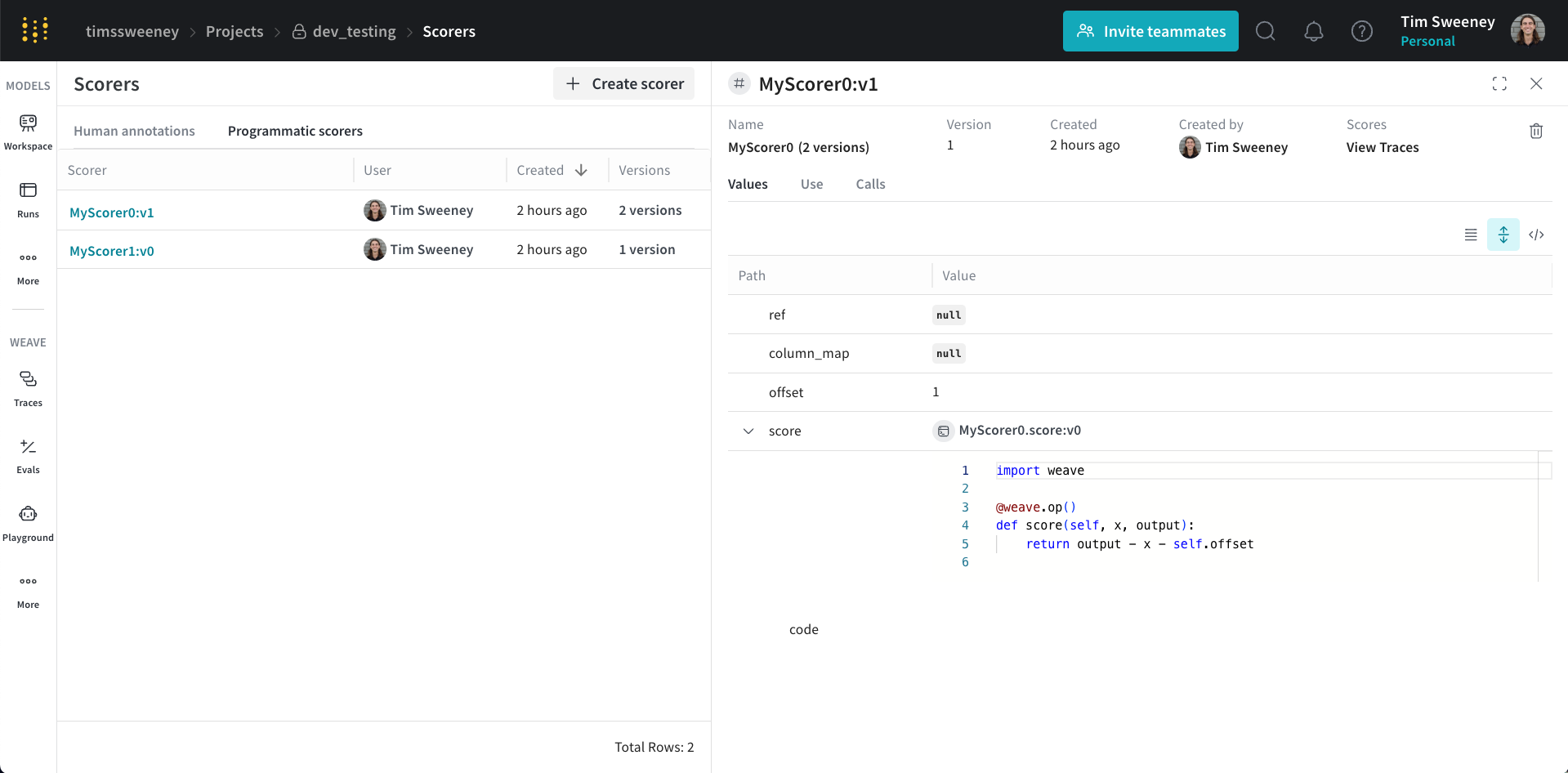

Scorer Details Page
Next, click the View Traces button under Scores to view all the calls scored by your Scorer.

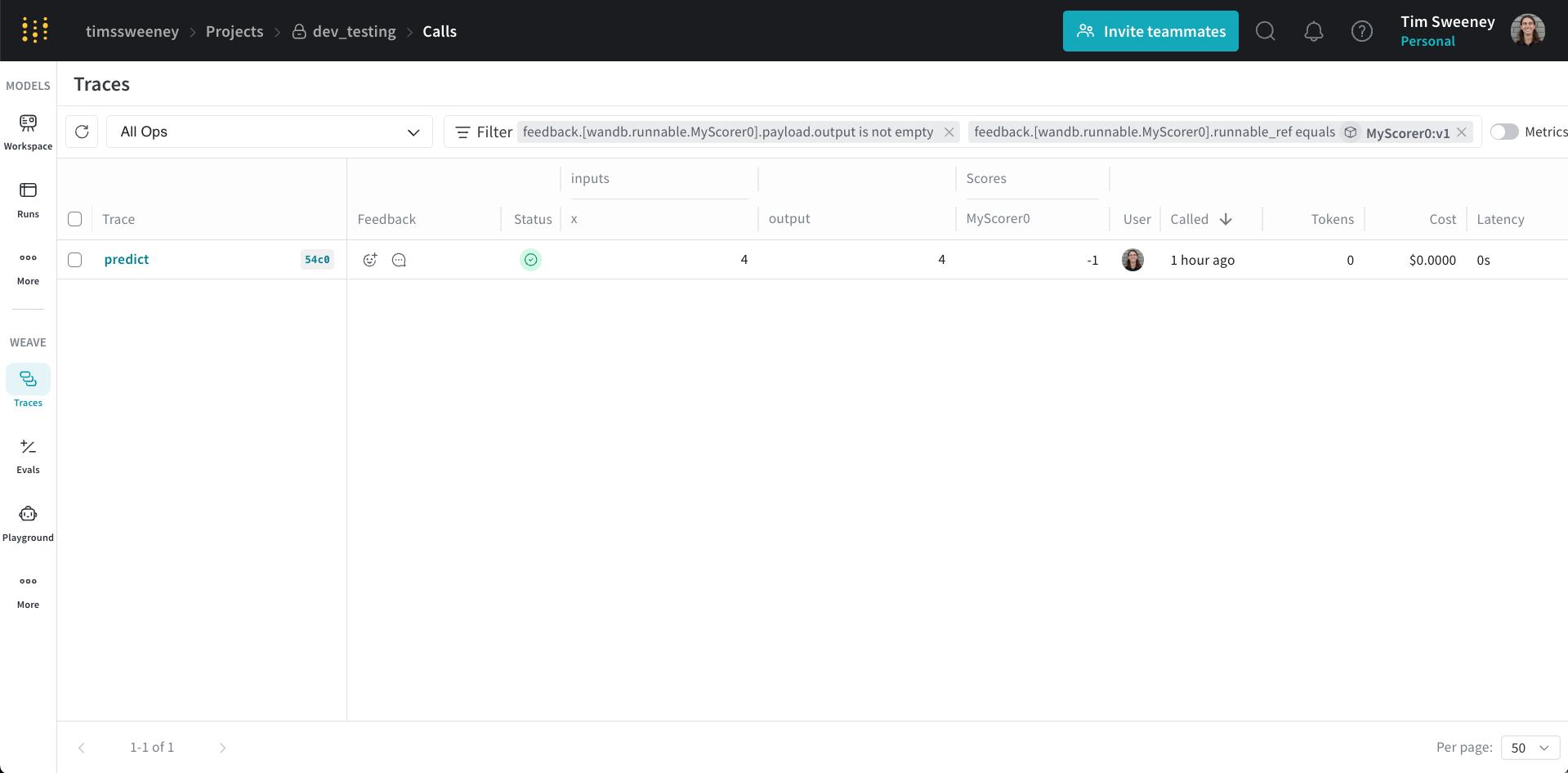

Filtered Calls to Scorer Version
This will default to the selected version of the Scorer. You can remove the version filter to see all the calls scored by any version of the Scorer.
Filtered Calls to Scorer Name
